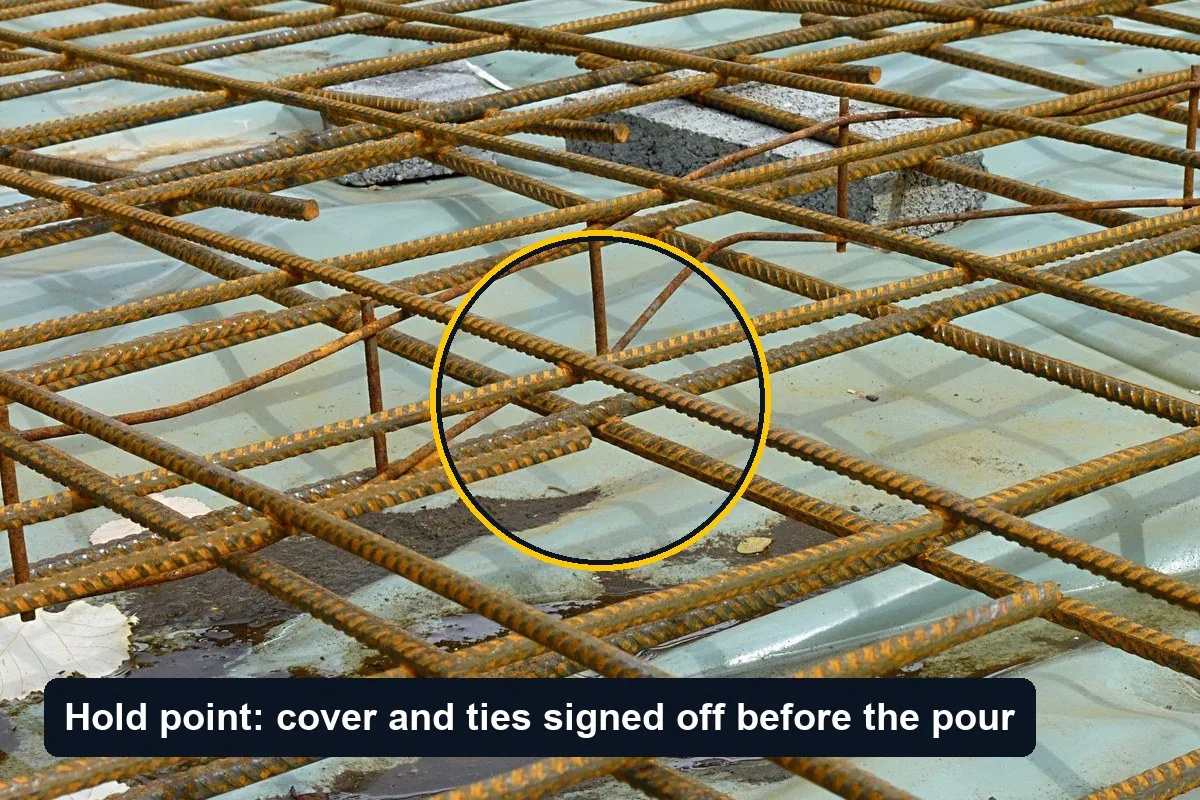

Close-up of a steel reinforcement mesh with tied bars over a slab, circled, with the label Hold point: cover and ties signed off before the pour
The classic hold point: reinforcement is inspected and released in writing before any concrete arrives. Photo: Jamain, CC BY-SA 3.0, via Wikimedia Commons (cropped and annotated)

Part of the guide: The Site Inspection Checklist to Run on Every Walkthrough

A hold point is a stage in the work that cannot be passed until a named person has inspected it and released it in writing: reinforcement before concrete is poured is the classic example. A witness point is a stage where that person must be given notice and may attend, but the work can continue if they do not. Both are set out in the inspection and test plan, the document that lists every check on a package of work, who does it, against what acceptance criteria, and what record is kept.

Hold points exist for work that will be hidden or impossible to check afterwards. Once concrete is in, the cover to the steel cannot be measured; once the ceiling is boarded, the fire stopping above it cannot be seen. That is also why they matter to anyone who writes punch lists: a defect caught at a hold point is one that never reaches the final snag.

Hold point, witness point, and the rest

Inspection and test plans usually use four kinds of intervention:

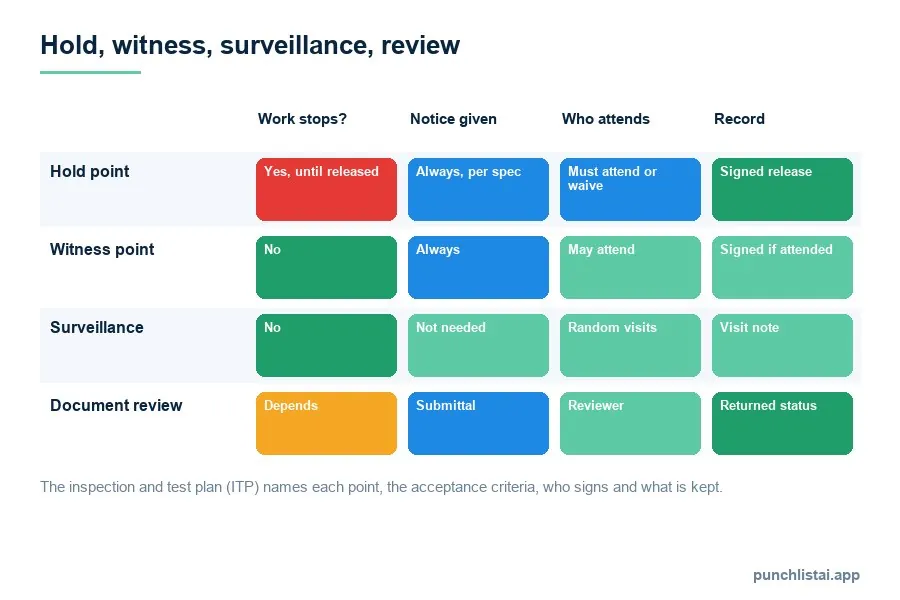

Comparison table of hold points, witness points, surveillance and document review: whether work stops, whether notice is given, who attends and what record is kept
Only a hold point stops the work. The others are about notice and records.
  • Hold point (H): work stops until the inspection is done and the release is signed. The inspecting party may release it, or waive the inspection in writing; silence is not a release.
  • Witness point (W): notice is given; the inspector may attend. If they do not, the contractor carries out the check and records it.
  • Surveillance (S): the client's or consultant's inspector may visit at any time, without notice.
  • Review (R): a document is checked, such as a test certificate or a method statement, rather than the work itself.

The letters vary between companies and specifications, and some plans add a monitor or a record-only category. What does not vary is the principle: the plan says in advance which stages stop the work.

Where hold points go on a building project

Typical hold points on building and civil work, all of them before something is covered:

  • Reinforcement, cover spacers, cast-in items and formwork before a concrete pour.
  • Excavation formation before blinding or foundations.
  • Drainage before backfill: line, level, joints, and the air or water test.
  • Waterproofing and tanking before it is covered, often with a flood test for wet rooms and roofs.
  • Fire stopping and cavity barriers before ceilings and linings close. See missing fire stopping around service penetrations.
  • First-fix services before plasterboard: pipework pressure tested, cables fixed and protected.

Witness points are used for checks the client wants to see but will not stop the job for: a pressure test, a sample panel, a commissioning run.

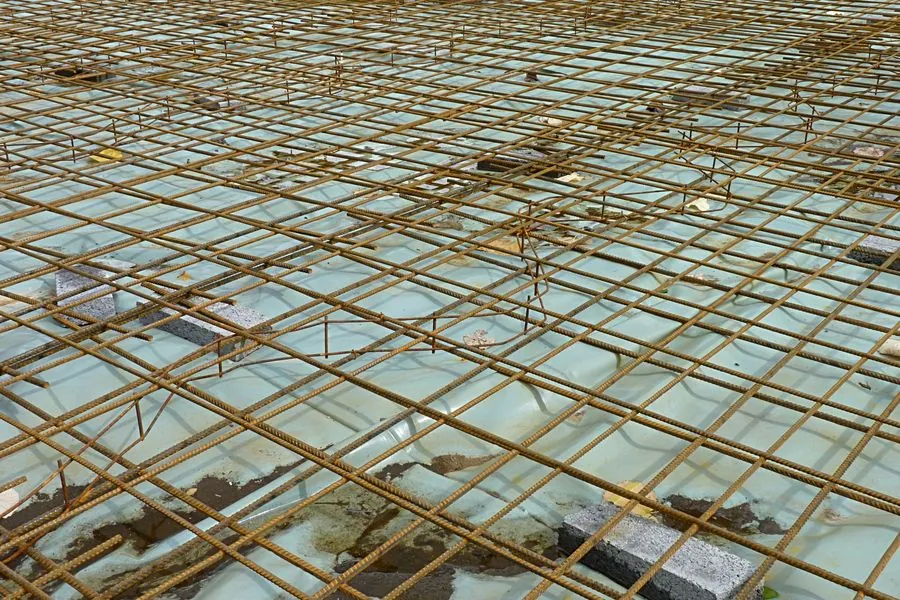

A reinforcement mat of ribbed steel bars laid over a slab before concrete is poured
Before the pour: bar sizes, spacing, laps, cover and ties can all be checked. Afterwards, none of them can. Photo: Jamain, CC BY-SA 3.0, via Wikimedia Commons (cropped)

Who does what

The contractor writes the inspection and test plan, usually from the specification, and the client's engineer or contract administrator accepts it before the work starts. On site, the contractor's own quality control inspects first and gives notice that the stage is ready, within the notice period the plan sets (24 or 48 hours is common). The client's or consultant's inspector attends, checks against the acceptance criteria and signs the release. On larger jobs, the design engineer, a third-party inspector or a building control officer may hold their own points on the same plan.

The record is the point of the exercise. A signed release, the date, the location and photographs of what was inspected are what show, years later, that the hidden work was checked. The photographs should show the element with its location, and a close-up with a tape or gauge where a dimension was checked, the same as for a defect: see how to photograph a construction defect.

What happens when a hold point fails

If the inspection finds a problem, the stage is not released. The contractor corrects it and gives notice again. A failure that cannot be corrected by simply finishing the work, or that has already been covered, is normally recorded as a non-conformance and dealt with through the plan's non-conformance procedure: the cause, the proposed remedy, and the engineer's acceptance. Pouring through a hold point without a release is itself a non-conformance on most projects, and the client can require the work to be opened up at the contractor's cost.

Common mistakes

  • Too many hold points. A plan with a hold on every activity stops the job and gets ignored. Keep them for work that will be hidden or cannot be tested later.
  • Releases by phone. A verbal "go ahead" leaves no record. The release is written, even if it is a photo of a signed sheet.
  • No acceptance criteria. "Check reinforcement" is not a criterion. The plan should point to the drawing, the bar schedule and the tolerance.
  • Records nobody can find. A folder of unnamed photos is not evidence. Name each record by the plan reference and the location.

What to do next

Go through your next package and mark the stages that will be hidden. Make those the hold points, put the acceptance criteria next to each, and agree the notice period and who releases. Then keep the record with the location and photos, the same way you would record a defect.

In Punch List AI, a checklist such as the first-fix inspection or the pre-drywall inspection works as a simple hold-point record: Pass, Fail or N/A on each check, a photo on each, and a Fail becomes an item with an owner and a due date.

Record your next hold point on your phone

Free to download. Checklist, photos and a dated PDF you can file with the inspection and test plan.

Download on theApp Store

Questions people ask

What is an ITP in construction?

An inspection and test plan: for each activity in a package of work, the check to be done, the acceptance criteria, who does it, whether it is a hold, witness, surveillance or review point, and what record is kept.

Can a hold point be waived?

Yes, by the party that holds it, in writing. The contractor cannot waive it, and no response is not a release.

What is the difference between a hold point and an inspection?

Every hold point is an inspection, but not every inspection is a hold point. The difference is that work cannot continue past a hold point until it is released.
