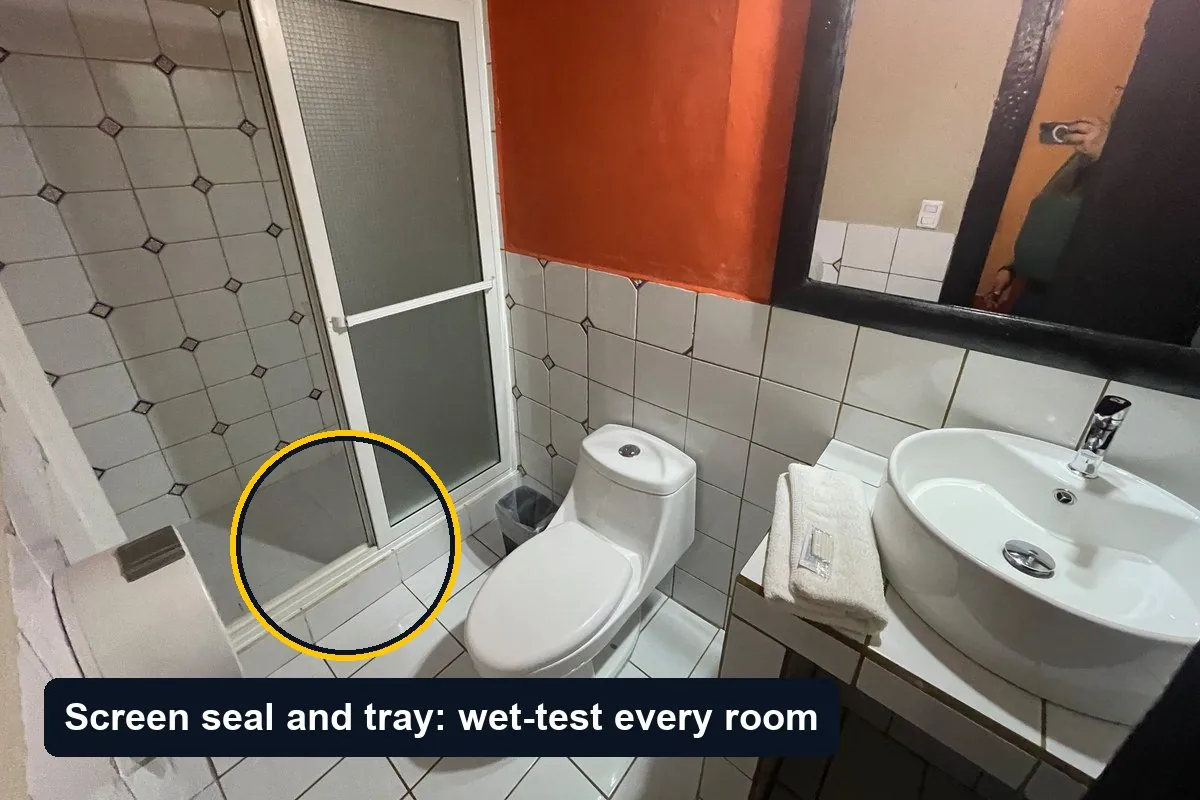

A hotel guest bathroom with a framed glass shower screen, toilet and vessel basin; the base of the shower screen is circled with the label Screen seal and tray: wet-test every room
The shower screen and tray are where hotel rooms fail first: run the water in every room. Photo: amslerPIX, CC BY 2.0, via Wikimedia Commons (cropped and annotated)

Part of the guide: The Site Inspection Checklist to Run on Every Walkthrough

A hotel room snagging list is the check of each guest room and its bathroom against the approved mock-up room and the brand standard before the room is released for sale. On a new hotel it runs floor by floor at practical completion; on a refurbishment, room by room as each block comes back. The contractor fixes building defects, the furniture and equipment supplier fixes its items, and the operator decides when a room is fit to sell.

What makes hotels different from housing is repetition. Two hundred rooms built to one design means the same defect appears two hundred times, and a list that is not organised by room number becomes unmanageable within a floor.

Start from the mock-up room

Most hotel projects build and approve a mock-up room early. It is the standard every other room is judged against: finishes, joinery tolerances, lighting levels, the height of every socket and the position of the hairdryer holder. Snag against the mock-up, not against your own idea of a good hotel room, and keep its approval record and photos to hand during the walk. A defect is a room that differs from the approved sample or from the specification, not a room you would have designed differently.

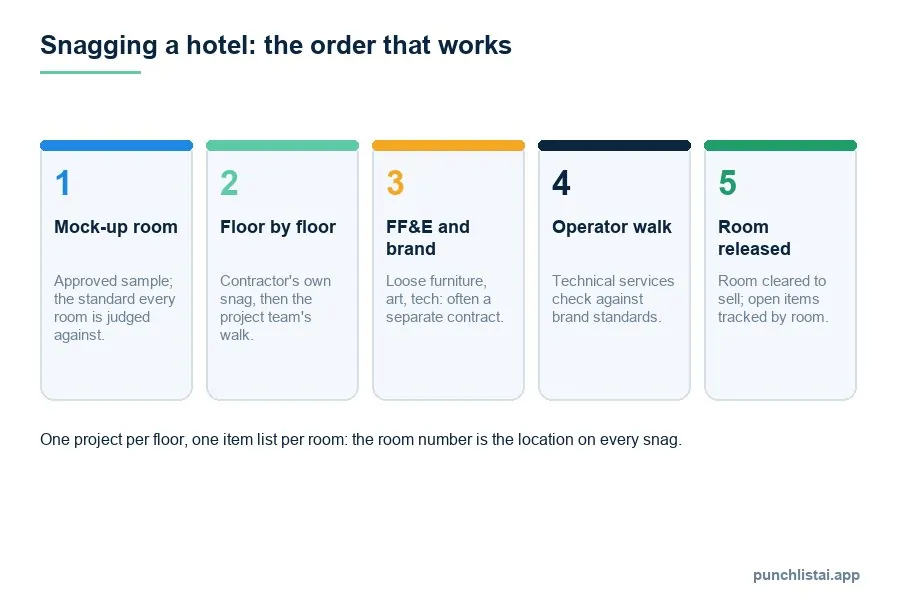

Five-step diagram of hotel snagging: approved mock-up room, floor by floor walks by the contractor then the project team, furniture and brand items, operator walk against brand standards, room released for sale
The order that keeps two hundred rooms under control: mock-up first, operator last.

Who walks the rooms, and when

  1. The contractor's own snag, floor by floor, while its trades are still on site.
  2. The project team's walk: the owner's project manager or technical adviser, the interior designer for finishes and the services engineer for the mechanical and electrical items.
  3. Furniture, fixtures and equipment. Loose furniture, art, televisions, safes and minibars are often a separate package with its own installer. Its snags go to that installer, not to the main contractor.
  4. The operator's walk. The operator's technical services or pre-opening team checks against the brand's standards and decides whether the room can be sold.

Each walk adds to the same list for the room. Separate lists per walk are the most common reason a room is reported as finished by one team and failed by the next.

What to check in every room

The hotel room snagging template has 27 checks in 6 areas: entry and wardrobe, bedroom, bathroom, lighting and electrical, hvac and acoustics, finishes. The items that come up again and again on hotel projects:

  • Entry door: closes and latches from any angle without slamming, the viewer and the privacy latch work, the card lock reads, the acoustic and smoke seals are continuous.
  • Connecting doors: both leaves lock, the seals are complete, and there is no light or sound through the gap. Guests notice this more than almost anything else.
  • Bathroom: the shower screen does not leak onto the floor with the shower running, silicone is continuous, the tray drains, grout is complete, and there is no hollow tile under foot.
  • Lighting and power: every scene and switch, bedside USB outlets, the TV and its data point, the key-card switch if there is one.
  • Heating, cooling and noise: the room reaches set point, the fan coil is quiet at low speed, the condensate drain does not drip, and blackout curtains close without a light gap.
  • Finishes and furniture: damage to corners and edges, carpet joints, marks on wallcovering, drawers and wardrobe doors aligned.
Hotel room snagging checklist template preview: 27 checks in 6 areas, with Pass, Fail and N/A boxes
Hotel room snagging: 27 checks in 6 areas. Print it or import it into the app.

Organising two hundred rooms

Set the list up so that a room number always finds its items:

  • One project per floor or per block, named the way the site team names them.
  • The room number as the location on every item, with the element after it: "Room 412, bathroom, shower screen".
  • An assignee on every item: main contractor trade, FF&E installer or operator.
  • A status the operator can read at a glance: open, ready for inspection, closed.

Patterns matter as much as individual snags. When the same connecting-door seal fails in thirty rooms, it is one conversation with the door supplier about the detail, not thirty tickets. Look at the list by trade and by item type every few days during the walks.

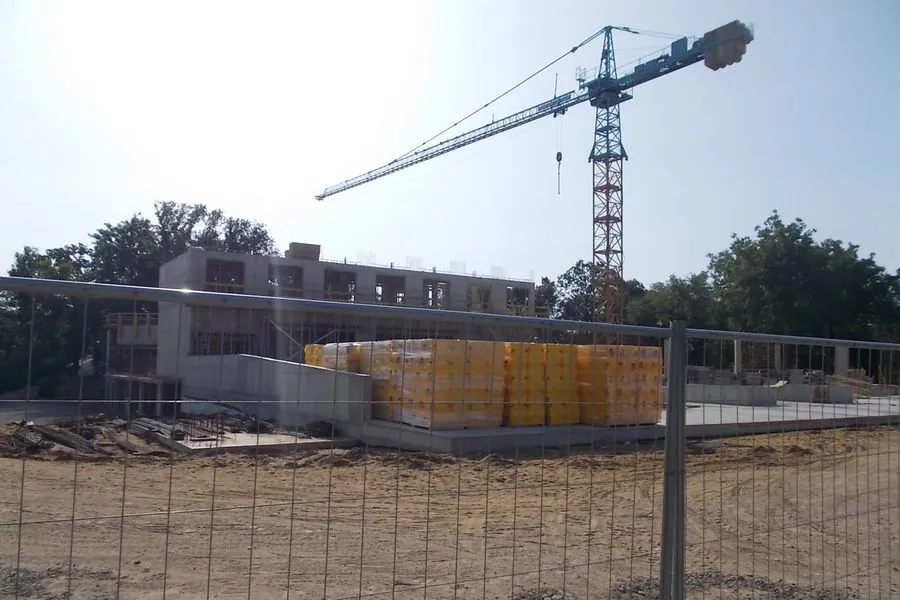

A hotel under construction with a tower crane, pallets of blocks and site fencing in the foreground
Rooms are snagged while the rest of the building is still a site. Protection of finished rooms is part of the job. Photo: Globetrotter19, CC BY-SA 3.0, via Wikimedia Commons (cropped)

Mistakes that delay opening

  • Snagging before the room is complete. Walking rooms that still have trades in them produces lists full of work in progress. Agree what "ready for snagging" means per room.
  • No protection after sign-off. A room signed off on Monday and damaged by a furniture delivery on Wednesday goes back to square one. Record the condition at release with photos.
  • Mixing building and FF&E items. The main contractor will not fix a scratched desk it did not supply. Assign each item to the right party from the start.
  • Testing nothing. Run every shower, every light scene and the cooling in every room. A visual walk misses the defects guests complain about first.

What to do next

Agree the mock-up as the standard, set up one list per floor with the room number as the location, and walk each room with the water and the power on. Keep one list per room across every walk, and close items only with a photo of the fix.

The hotel room template in Punch List AI walks the room area by area; a Fail becomes a snag with the room and trade filled in, and the report prints the checklist for each room as an appendix.

Snag the next floor on your phone

Free to download. Import the hotel room template, name the project after the floor, and walk.

Download on theApp Store

Questions people ask

How long does it take to snag a hotel room?

Allow roughly 20 to 40 minutes for a standard room with its bathroom, including running the water and the lighting scenes. Suites and accessible rooms take longer.

Who fixes damaged furniture found during snagging?

The party that supplied and installed it, often a separate furniture and equipment contractor. Damage caused by other trades is recorded against the trade that repairs it, and the cost is settled separately.

Should every room be snagged, or a sample?

Every room. Repetition hides defects that only occur in some rooms, and the operator will check every room before selling it.
